1. Capacity & Scheduling (OPTIONAL Module)
1.1. Dynamic Production Scheduling
1.1.1. Prerequisites for Dynamic Production Scheduling
Setup Required:

ManEx’s standard module configuration allows most users to accomplish their daily tasks.  For those users wanting to get more from ManEx by leveraging the total solutions, this is one of the optional modules available for purchase. This screen provides visibility of all open and scheduled orders. To place an order or to learn more about this specific module or any of the other optional modules please contact us at http://manex.com\contactus.aspx


After activation, "Dynamic Production Scheduling" access for each user must be setup in the ManEx
System Security module.  Users with “Supervisor Rights” will automatically have access.


User MUST activate the Re-Schedule trigger and setup e-mail for the notification. This trigger will re-schedule all of the jobs that were scheduled and still open. The purpose is to recalculate “In” and “Out” date/time for the Work Centers to make capacity view more accurate, otherwise in/out of the WC will not recalculate (only priorities of the job are) and capacity view will be always off.


The Dynamic Production Schedule module is based on the following setup:

In System Setup for Shop Floor Tracking Defaults the system assigns the Average Hrs/Work Day as 24 hours.



The prcoess time within the Dynamic Production Schedule module is calculated from the Setup and Run time entered in the Work Center and Activities Routing Setup.



The Production Capacity Setup module.




Also check the status of the Work Order of interest – it can not be on Administrative Hold (for example), to complete the scheduling.

1.1.2. Introduction for Dynamic Production Scheduling
This screen provides visibility of all open and scheduled orders.  Users are able to see when capacity constraints may hinder production and any time in the future.  This module can provide sufficient notice to adjust the production schedule or adjust capacity to maximize production and meet promised delivery dates.  It will also indicate when a job will not be completed on time based on processing time remaining and the current due date.

This module will aide in managing jobs by the work orders and/or work centers based on customer requirements (due date or complete date).  The work orders can be managed by work center with the ability to prioritize within each work center.  This module will allow you to view and schedule the workload to ensure deadlines are met.  The system will assume that you have a 24 hour capacity shop.  The idea behind the work order schedule module is not to predict when the job will move through the shop, but to accurately prioritize the job so the user knows which job has to be processed first.  To get a better understanding on how this module calculates the priority for a job see the attached word document <Production Schedule Module>.

The Work Center Tab - allows user to view all the work orders scheduled for a specific work center
The Work Order Tab -  allows the user to schedule the work order
The Unscheduled Tab - displays all Work Orders with a status of "Open" that are not scheduled
The Late Tab - displays a list of Work Orders that have exceded the WO due date, unless they have opt to use the Trigger then it will display a list of Work Orders that have exceded the Complete Date
The Hold Tab - displays a list of Work Orders that have a status of "Hold"
The Back Log Tab - displays a list of Work Orders with a status of "Open" that have been scheduled and still have a balance remaining
1.1.3. Fields and Definitions for Dynamic Production Scheduling
1.1.3.1. Work Center
The Work Center Tab - allows user to view all the work orders scheduled for a specific work center







Work Center Tab Fields and Definitions

Part Number
The part number of the assembly being built for the line item highlighted in the box below.
Rev
The revision of the part number of the assembly being built for the line item highlighted in the box below.
Class
This field lists the Class of the assembly being built for the line item highlighted in the box below.
Type
This field lists the type of the assembly being built for the line item highlighted in the box below.
Description
This field is the description of the assembly being built for the line item highlighted in the box below.
Customer
This field lists the customer that the assembly highlighted in the box below is being built for.
Current Work Center
This field lists the Work Center currently choosen.
Next Work Center
This field lists the Next Work Center for the assembly highlighted in the box below.
Due Out
This field lists the date the assembly is due out of this work center.
Work Order #
This field lists the assigned Work Order number.
Priority
This field displays the priority setup in the Work Order screen.
WC Qty
This field displays the quantity in the current work center.
WC Process Time (Hours)
This field displays the time available to process the current work center.
WC Process Time (New Hours) This field displays the actual time scheduled to process the current work center
Complete Date
This field displays the completed date entered in the work order screen.
Order Qty
This field displays the total order quantity.
Balance
This field displays the balance left to move into FGI.

Depress this button will display the WIP(Work-in-Process) from Shop Floor Tracking  for the line item highlighted.
Depress this button will allow the users to create or view the Work Order notes.  This button will display in RED if any notes are available.
Depress this button will allow the users to create or view the Work Center notes.  This button will display in RED if any notes are available.
Depress this button to display any shortage for the work order highlighted.
Depress this button to display Jobs in the prior Work Centers.
1.1.3.2. Work Order Tab

The Work Order Tab
-  allows the user to schedule the work order




Work Order Tab Fields and Definitions

Work Order
This field lists the assigned Work Order number.
Part Number
The part number of the assembly assigned to this Work Order.
Customer
This field lists the customer assigned to this Work Order.
Wk Ord Qty
This field displays the total Work Order quantity.
Balance
This field displays the balance left to move into FGI.
Due Date
This is defaulted in from the Due date entered on the Work Order.
Schedule Start Date
This is the date the user would enter to begin the Work Order.  (The current date defaults in)
Schedule Complete Date
This is the date the user would enter when the Work Order is to be completed. (The due date from the work order defaults in)
Work Center
These are the Work Centers assigned to this Work Order.
Date Out
This is the date the system has calculated (based on the setup and run times per each work center) that the product will need to be transfered out of this work center in order to meet the completion date.
Setup Time (Minutes)
This is Setup time for the full Wk Ord Qty.  (for example if .10 seconds is entered in the Work Order Traveler module for a specific Work Center x 60) = 6.00 minutes.
Run Time (Minutes)
This is the Run Time entered in the Work Order Traveler module  (for example .060 seconds) x 60 = 3.60 minutes.
Priority
User can enter the priority they would like this product completed.
Quantity
This field displays the quantity in the current work center.
Process Time Required (H) This is the Setup time (6.00 min divided by 60= .10 hours) plus the total Run time (3.60 minutes x WK Order Qty (1000) = 3600 minutes divided by 60 = 60 hours) = 60.10 hours.
WC Average Capacity

Depress this button to create the schedule once the Schedule start date and Schedule complete date have been entered.

Depress this button will allow the users to create or view the Work Order notes.  This button will display in RED if any notes are available.
Depress this button to display any shortage for the work order highlighted.
Depress this button will allow the users to create or view the Work Center notes.  This button will display in RED if any notes are available.
Depress this button will allow the users to create or view the Work Order/Work Center notes.  THis button will display in RED if any notes are available.
1.1.3.3. Unscheduled Tab

The Unscheduled Tab - displays all Work Orders with a status of "Open" that are not scheduled




Unscheduled Tab Field and Definitions

Work Order # This field lists the assigned Work Order number.
Part Number The part number of the assembly being built for the line item highlighted.
Rev The revision of the part number of the assembly being built for the line item highlighted.
Customer This field lists the customer that the assembly highlighted.
Order Qty This field displays the total order quantity.
Completed This field displays the quantity complete.
Balance This field displays the balance left to move into FGI.
Due Date This is defaulted in from the Due date entered on the Work Order.
1.1.3.4. Late Tab
The Late Tab - displays a list of Work Orders that have exceded the WO due date, unless they have opt to use the Trigger then it will display a list of Work Orders that have exceded the Complete Date


 Late Tab fields and Definitions

Work Order # This field lists the assigned Work Order number.
Part Number The part number of the assembly being built for the line item highlighted.
Rev The revision of the part number of the assembly being built for the line item highlighted
Customer This field lists the customer that the assembly highlighted.
Order Qty This field displays the total order quantity.
Completed This field displays the quantity complete
Balance This field displays the balance left to move into FGI.
Complete Date This field displays the completed date entered in the work order screen.
Priority This field displays the priority setup in the Work Order screen.
Process Time (Hours) This field displays the time needed to process the current work center.


The user may sort by Work Order, Product Number, Build quantity, Complete, Balance or Completion Date by depressing the header buttons.
1.1.3.5. Hold Tab

The Hold Tab - displays a list of the Work Orders that have a status of either “Administrative Hold” or “Manufacturing Hold” on them:





Hold Tab fields and Definitions



Work Order # This field lists the assigned Work Order number.
Part Number The part number of the assembly being built for the line item highlighted.
Rev The revision of the part number of the assembly being built for the line item highlighted.
Customer This field lists the customer that the assembly highlighted.
Order Qty This field displays the total order quantity.
Completed This field displays the quantity complete.
Balance This field displays the balance left to move into FGI.
Complete Date This field displays the completed date entered in the work order screen.
Priority This field displays the priority setup in the Work Order screen.
Process Time (Hours) This field displays the time needed to process the current work center.


The user may sort the display by clicking on the Work Order, Product Number, Build Quantity, Complete, Balance or Complete Date header buttons.
1.1.3.6. Backlog Tab
The Backlog Tab - displays a list of Work Orders with a status of "Open" that have been scheduled and still have a balance remaining



Backlog Tab fields and definitions

This button gives the user the capability to manually reschedule all currently scheduled jobs to maintain WC due out dates within the Dynamic Scheduling module.


Work Order # This field lists the assigned Work Order number.
Part Number The part number of the assembly being built for the line item highlighted.
Rev The revision of the part number of the assembly being built for the line item highlighted.
Customer This field lists the customer that the assembly highlighted.
Order Qty This field displays the total order quantity.
Completed This field displays the quantity complete.
Balance This field displays the balance left to move into FGI.
Complete Date This field displays the completed date entered in the work order screen.
Priority This field displays the priority setup in the Work Order screen.
Process Time (Hours) This field displays the time needed to process the current work center.



The user may sort by Work Order, product Number, Build Quantity, Complete, Back Order or Completion Date by clicking on the header buttons.

1.1.4. How To ...... for Dynamic Production Scheduling
1.1.4.1. Find Work Order

Enter Production/Capacity & Scheduling/Dynamic Production Scheduling Module

The following screen will appear:






Depress the Work Order tab.  The following screen will appear:


Depress the Find button.


The following selection will be displayed:


If you select by Work Order Number, Product Number, Customer Name, or Sales Order Number one of the following lists will be displayed:

Enter the data into the red box or highlight the item of interest and double click on it.



The Work Order selected will appear on the screen:



Depress the Exit button. Depress the Save button.




1.1.4.2. Find Work Center
Clicking on the Work Center tab brings up the following screen:





Depress the Find button and the following Work Center selection will be displayed:

Highlight and double click for the Work Center of choice.

The following will appear for all of the Work Orders listed in the Work Order tab.  The user may sort on any of the following buttons:  Due Out, Work Order #, Priority, WC Qty, WC Process Time, Complete Date, Order Qty, or Balance.




Depressing the WIP (Work in Process) button for the Work Order highlighted will bring up the following screen :

The quantity currently in each Work Center will display


Depressing the WO Note button will bring up the Notes entered in the Work Order Screen. To add a note, depress the Edit button, type in the note and depress the Save button.

Depress the WC Note button will bring up the notes entered in SFT per work center, for the Work Order highlighted. To add a note, depress the Edit button, type in the note and depress the Save button.

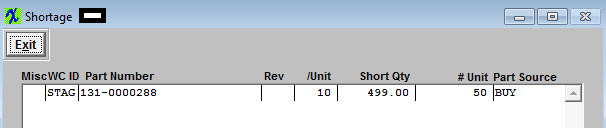

Depressing the Shortage button will bring up the following for the Work Order highlighted:



1.1.4.3. Schedule a Work Order
Begin by Finding a Work Order, by depressing the Find button, or open the UnScheduled screen.



Highlight an Unscheduled Work order, then go to the Work Order screen:


To schedule, click on the Edit Button and type in your password.



Todays date will default in the Scheduled Start Date and the Work Order Due date will default in the Scheduled Complete date.  User may change these dates if necessary.

Note:  If the system cannot schedule by the given Schedule Complete Date (based on the process time required) it will schedule by the earliest possible date. Note:  The Schedule Complete Date may not match the Completion Date or Last Date Out.  System will not allow the Schedule Complete Date to be earlier that the Scheduled Start Date. User will receive the following warning if they have have entered a Schedule Complete Date earlier that the Schedule Start Date and will be required to change the Schedule Complete Date, before proceeding.





Depress the Schedule button and the system will schedule the work order using the data entered in the
Work Order Traveler Setup module.



User can setup the Priority for each individual work centers within the Work Order screen, create or view the Work Order and/or Work Center Notes, and view any shortages for this Work order as displayed in the following screen..


Depress the Exit button.  Depress the Save button to save the schedule. Depress the Abandon Changes button to abandon the schedule.
User will then receive a prompt upon saving asking if user would like to schedule another job, and if yes it will open the "Find" window and continue to the "Edit" mode without asking for the password again.



1.1.4.4. Re-Schedule a Work Order

Find a Scheduled Work Order, depress the Edit Button, and enter your password.





Depress the Exit button.

Once user has completed the changes they may depress the Save button, to save the changes or the Abandon changes button to abandon the changes.


NOTE:  There is also a Capacity Planning Trigger option that my be setup to re-schedule all of the jobs that were scheduled and still open automatically.  When the trigger runs, it will recalculate the "In" and "Out" date/time for the Work Centers so the capacity view is current.




1.2. Capacity Critical Path
1.2.1. Prerequisites for Capacity Critical Path

After activation, "Dynamic Production Scheduling" access for each user must be setup in the ManEx System Security module.  Users with “Supervisor Rights” will automatically have access.


A Production Schedule must be setup for the Work Order

1.2.2. Introduction for Capacity Critical Path
1.2.3. Fields and Definitions for Capacity Critical Path
1.2.3.1. Work Center Tab



To create a graph, select Work Center(s), by clicking on the appropriate radial.  Depress "All" to view the graph for all Work Centers.  Depress "One" to view the graph for only one Work Center.

Depress the radial to view the period you want the graph to cover, Daily, Weekly or Monthly.  Note:  It is the capacity and load for 10 (days, weeks, months)  The tools tips for the radio buttons shows the explanation

From Type in the From date.

Depress this button to generate the graph.

Current Work Center
This field will be visible when "All" is selected and will display the current work center being viewed.
Depress this button to view the chart in 3D/2C
Work Center Capacity Summary The graph will be displayed in this section based on the selections. The bar graph will include all jobs that affect the load (including jobs that are on any type of Hold), so users are not misled about the available capacity.   The grid below will display the status of the job and if the user feels that a job should not be included they may re-schedule it to a future date.
Priority This field displays the priority setup in the Work Order screen.
Work Order Competion Date

This field displays the completed date entered in the work order screen.

Work Order

This field lists the assigned Work Order number.

Part Number This feild lists the assigned part number of the assembly being built.
Rev The revision of the part number of the assembly being built.
Balance This field displays the balance left to move into FGI.
Status The status of the Work Order
Customer This field lists the customer that the assembly is being built for.

1.2.3.2. Work Order Tab

Work Order This field lists all Open (not closed, or cancelled) Work Orders (in work order due date order, earliest first),  to select from once the selection has been made it will display the Work Order the graph is being displayed for.
Depress this button to generate the graph
Work Order Load The graph will be displayed in this section based on the Work Order selected.
1.2.4. How To ...... for Capacity Critical Path
1.2.4.1. Create a Graph
Enter the Production/Capacity &Scheduling/Capacity Critical Path module

The following screen will appear:


To create a graph, select Work Center(s), by clicking on the appropriate radial     If One is chosen the Work Order Selection screen will appear:


Highlight a Work Center.

Decide what period you want the graph to cover, Daily, Weekly or Monthly.

Type in the From date. Depress the      button to generate the graph.



The bar graph will include all jobs that affect the load (including jobs that are on any type of Hold), so users are not misled about the available capacity.   The grid below will display the status of the job and if the user feels that a job should not be included they may re-schedule it to a future date.


To display the detail click on the bar within the BLUE and the detail information for that date will be displayed at the bottom of the screen.  The WOs display at the bottom of the screen are sorted by complete date (disregarding the time).  User may sort the display at the bottom of the screen, by depressing any of the Header titles.   The GREEN on the bar means NO capacity and the RED on the bar means over capacity.



A drill down to the Production Schedule module is available within this screen.  If user double clicks on a specific Work Order number in the "Work Order" column the Production Schedule module will open for that work order on the schedule screen, so user may view, edit, etc.  When user is finished viewing the Production Schedule module, they may depress the exit button, and it will bring you back to the Capacity Critical Path screen.

Note:  The graph and the grid may get out of synchronization. If that happens simply click on the “3D/2D” button. The graph button will work also, but may take longer because it will go through the whole process of collecting the data again.


WORK ORDER TAB

Depressing on the Work Order tab will bring up the following:



Select the desired Work Order from the pull down.  Depress the      button to generate the graph.



The dates and times displayed in the blue boxes are the dates and times that the product is due to be moved out of the Work Center per the Production Schedule module.




1.3. Production Capacity Setup
1.3.1. Prerequisites for Production Capacity Setup
The following setup is required before the user will be able to use the Production Capacity Schedule.

After activation, "Production Capacity Setup" access for each user must be setup in the ManEx System Security module.  Users with “Supervisor Rights” will automatically have access.


Work Shifts must be setup in the Work Shift setup  module.  The more work hours you have the higher your capacity.



In System Setup for Shop Floor Tracking Defaults the system assigns the Average Hrs/Work Day as 24 hours.




The Activity Costing Description and Activity Setup Type Description must be setup in the Activity Costing & Setup Type Setup module.


Shifts and activities must be entered to each application Work Center in the Production Work Centers & Activities module.


Within the Activity screen, the user checks the Cap Totaling box and enters the applicable Activity Costing information.



The Work Center Activity Setup and Run Times must be entered in the Work Order Traveler Setup module for any applicable product.


Check the status of the Work Order of interest – it can not be on Administrative Hold (for example), to complete the scheduling.

1.3.2. Introduction for Production Capacity Setup

Capacity is at units/hour/operator-machine. Capacity then depends on the number of resources available, and that includes the number of shifts available. The program determines the duration of the job based on the resources, shifts, and active time during shifts (breaks and meals are excluded). The capacity planning module will stack up the requirements for multiple jobs on the same day and either require the user to add resources, or extend the completion time.

Once the extensive setup requirements are met, the user may add a resource assignment. There are two views available in the Production Capacity Setup module.  The Capacity Summary screen and the Activity Capacity View screen.

From there, the user can enter the Dynamic Production Scheduling module and re-schedule Work Orders.

There is also the opportunity to graphically view the Capacity Critical Path.

1.3.3. Fields and Definitions for Production Capacity Setup
1.3.3.1. Capacity Summary Screen



Work Center List of all the Work Centers setup in the Production Work Center and Activities module.
Sh No The shift number setup in the Work Shift Setup module.
Description The description of the shift setup in the Work Shift Setup module.
From The beginning of the shift.
To The end of the shift.
Total Hrs Total time actually working, does NOT including breaks and lunches.

Selected Work Center Daily Capacity

Hours The total hours required for the work center highlighted, based on the shift hours and the resource..
Volume The total volume for the work center highlighted based on the shift hours, resource, and standard rate.









1.3.3.2. Resource Setup Screen



Work Center A List of all the Work Centers setup in the Production Work Center and Activities module
Activity A List of Activities for the Work Centers setup in the Production Work Center and Activities module.
Cap

Notice there are three activities listed, but only 2 of them (“Activity-1” and “Activity-5”) will be calculated in the capacity because the “Cap” box has been checked in the Production Work Centers & Activities module.

Sh No Shift Number assigned to the Work Shift in Work Shift Setup
Description The description of the shift setup in the Work Shift Setup module.
From The beginning of the shift.
To The end of the shift.
Total Hrs The total hours for the shift.
Resource Assignment
This could be the number of people working during one given shift on a particular day or number of machines, or both, it is up to the user to decide.  The capacity for the given work center will be calculated by multiplying working hours for all the shifts set for any given WC on any give day times resources. Example:  If WC1 has one 8 hour shift set on Monday with number 8 (8 people) as a resource during this shift, the capacity for WC1 for that day would be 8*8=64 hours.

NOTE: Each time a user enters the Capacity Setup module, the program checks the current date, and updates the month in the "Resource Assigment" grid to show the 12 months from current month.  For Example:  If the last time a user entered the module was March, so the 12 months are March/2008 to February/2009 (as displayed below).  If user re-enters this module in June, the program will change the 12 months to June/2008 to May/2009 and also assign "1" to the 3 new new added months (March, April, and May/2009).
1.3.3.3. Activity Capacity View Screen


Work Center A List of all the Work Centers setup in the Production Work Center and Activities module.
Activity A List of Activities for the Work Centers setup in the Production Work Center and Activities module.
Cap Notice there are three activities listed, but only 2 of them (“Activity-1” and “Activity-5”) will be calculated in the capacity because the “Cap” box has been checked in the Production Work Centers & Activities module.
Sh No Shift Number assigned to the Work Shift in Work Shift Setup module.
Description The description of the shift setup in the Work Shift Setup module.
From The beginning of the shift.
To The end of the shift.
Total Hrs The total hours for the shift.

Selected Activity Daily Capacity

Hours The total hours required for the work center highlighted, based on the shift hours and the resource.
Volume The total volume for the work center highlighted based on the shift hours, resource, and standard rate.


1.3.4. How To ....... for Production Capacity Setup
1.3.4.1. Production Capacity Setup

Enter Production/Capacity & Scheduling/Production Capacity Setup

The following screen will appear.  Each Work Center can have different shifts associated with it, but it must have at least one before you can enter the Resource Assignment info.




 To setup the Resources and Capacity pertaining to a Work Center, Activity and Shift, depress the Resource Setup tab.





Each time a user enters the Capacity Setup module, the program checks the current date, and updates the month in the "Resource Assigment" grid to show the 12 months from current month.  For Example:  If the last time a user entered the module was March, so the 12 months are March/2008 to February/2009 (as displayed below).  If user re-enters this module in June, the program will change the 12 months to June/2008 to May/2009 and also assign "1" to the 3 new new added months (March, April, and May/2009).

Notice there are three activities listed, but only 2 of them (“Activity-1” and “Activity-5”) will be calculated in the capacity because the “Cap” box has been checked in the Production Work Centers & Activities module.


To add/change a Resource Assignment, depress the Edit button and type in your password.  Type in the required Resource Assignment. Depress the Save button to save changes or depress the Abandon Changes button to abandon changes.



User may enter a different Resource Assignment number in each month for each activity/shift.  Example for March:  Activity-1 Day Shift is 2 and Swing Shift is 1;  Activity-5 Day Shift is 2 and Swing Shift is 2.

The Activity-1 Standard Rate is 12.00 and the Activity-5 Standard Rate is 5.00  (Setup in the Production Work Centers & Activities module)


The way the system calculates the hours and volume is:

Monday:   has only the Swing Shift but is associated with both Activity-1 and Activity-5.


Hours:   (7.5*1) + (7.5*2) = 22.50  or  (Swing Shift hours x Resource Assignment for Activity-1) (Print Screen 2)  plus  (Swing Shift hours x Resource Assignment for Activity-5) (Print Screen 4)   =  22.50

Volume:
   (7.5*1*12) + (7.5*2*5) = 165.00  or  (Swing Shift hours x Resource Assignment for Activity-1) (Print Screen 2)  x  Standard Rate for Activity-1 (12.00) =  90.00  plus  (Swing Shift hours    x   Resource Assignment for Activity-5) (Print Screen 4)   x Activity-5 Standard Rate (5.00)  =  75.00   for a total of  165.00



Tuesday:  The same as Monday

Wednesday:  has both the Day Shift and the Swing Shift and is associated with both Activity-1 and Activity-5.

Hours:   (4.28*2 + 7.5*1) + (4.28*2 + 7.5*2) = 39.633   or  (Day Shift hours x Resource Assignment for Activity-1) (Print Screen 1)  plus  (Swing Shift hours x Resource Assignment for Activity-1) (Print Screen 2) = 16.06   plus   (Day Shift hours x Resource Assignment for Activity-5) (Print Screen 3)  plus  (Swing Shift hours x Resource Assignment for Activity-5) (Print Screen 4)  =  23.56  for a total of  39.633

Volume:  (4.28*2 + 7.5*1)*12  +  (4.28*2 + 7.5*2)*5 =  310.633   or   (Day Shift hours x Resource Assignment for Activity-1) (Print Screen 1)  plus  (Swing Shift hours x Resource Assignment for Activity-1) (Print Screen 2)  x  Activity-1 Standard Rate  (12.00)  =  192.72   plus   (Day Shift hours x Resource Assignment for Activity-5) (Print Screen 3)  plus  (Swing Shift hours x Resource Assignment for Activity-5 (Print Screen 4) x Activity -5 Standard Rate  (5.00) =  117.80  for a total of   310.52



(The screen calculates from minutes, not by hours, so there may be a little bit of a difference.)

Thursday:  The same as Wednesday

Friday:  The same as Wednesday

Saturday:  The same as Monday

Sunday: The same as Monday


To refresh the view in the Capacity Summary tab, highlight the Work Center of interest.  Then highlight the shift of interest.  The view in the Selected Activity Daily Capacity windows will update.

For each Work Center, the user may view the Capacity Setup.  Depress the down arrow next to the Work Center field.  Highlight the applicable Work Center.  Highlight the Activity.  Highlight the Shift.  The view in the Selected Activity Daily Capacity windows will update.



1.4. FAQ - Capacity & Scheduling
Facts and Questions for the Capacity and Scheduling Modules
